SciELO - Scientific Electronic Library Online


vol.30 issue1Isivivane, Freedom Park: A critical analysis of the relationship between commemoration, meaning and landscape design in post-apartheid South AfricaEarly sustainable architecture in hanging skyscrapers - a comparison of two financial office buildings author indexsubject indexarticles search
Home Pagealphabetic serial listing

Services on Demand

Article

Indicators

    Related links

    • On index processCited by Google
    • On index processSimilars in Google

    Share


    Acta Structilia

    On-line version ISSN 2415-0487
    Print version ISSN 1023-0564

    Acta structilia (Online) vol.30 n.1 Bloemfontein  2023

    http://dx.doi.org/10.38140/as.v30i1.6988

    RESEARCH ARTICLE



    Optimisation of labour-intensive productivity for construction projects in Ghana





    Emmanuel Bamfo-AgyeiI, II; Didibhuku Wellington ThwalaIII; Clinton AigbavboaIV

    IDepartment of Construction Technology and Management, Cape Coast Technical University, Ghana
    IIDepartment of Civil Engineering, UNISA, South Africa. Email: <emmanuel.bamfo-agyei@cctu.edu.gh>, ORCID: https://orcid.org/0000-0003-3097-1644
    IIIDepartment of Civil Engineering, University of South Africa, South Africa. Email: <thwaladw@unisa.ac.za>, ORCID: https://orcid.org/0000-0002-8848-7823
    IVDepartment of Construction Management and Quantity Surveying, University of Johannesburg, South Africa. Email: <caigbavboa@uj.ac.za>, ORCID: https://orcid.org/0000-0003-2866-3706






    ABSTRACT

    The construction industry in Ghana is labour-intensive and relies heavily on the skills of its workforce. No coordinated policy framework has been implemented or developed to guide and mainstream the application of labour-intensive methods in Ghana's development process. The aim of this article is to develop a framework for optimising labour-intensive productivity for construction work. The article adopted a quantitative research design, using a questionnaire survey to determine the factors influencing labour-intensive productivity in the Ghanaian construction industry. Records available at the Ghana Social Opportunity Project (GSOP) indicate that there are 920 professionals involved in labour-intensive works on road infrastructure. A purposive sampling technique was used to select 40 districts that were into road construction projects; from these, 560 respondents were considered. Descriptive statistics and inferential statistics were used for the data analysis. Principal axis factor analysis revealed six components in the three labour-productivity categories with eigenvalues above 1 that may influence the optimisation of labour-intensive productivity for construction projects in Ghana. These comprise equipment and tools, material and temperature. Optimising labour-intensive productivity in construction works requires the involvement of all stakeholders, including project managers, workers, suppliers, and subcontractors. By implementing the six components in the proposed labour productivity framework, construction projects can achieve increased productivity, cost savings, and improved outcomes. The framework may help policymakers in the construction industry review the existing national policies that are geared towards helping indigenous firms in improving productivity in the construction industry.

    Keywords: Construction, equipment, labour-intensive construction work, labour-productivity framework, material, productivity, temperature


    ABSTRAK

    Die konstruksiebedryf in Ghana is arbeidsintensief en maak staat op die vaardighede van sy arbeidsmag. Geen gekoördineerde beleidsraamwerk is geïmplementeer of ontwikkel om die toepassing van arbeidsintensiewe metodes in Ghana se ontwikkelingsproses te lei nie. Die doel van hierdie artikel is om 'n raamwerk te ontwikkel vir die optimalisering van arbeidsintensiewe produktiwiteit vir konstruksiewerk. Die artikel het 'n kwantitatiewe navorsingsontwerp aangeneem wat 'n vraelysopname gebruik het om die faktore te bepaal wat arbeidsintensiewe produktiwiteit in die Ghanese konstruksiebedryf beïnvloed. Rekords beskikbaar by die Ghana Social Opportunity Project (GSOP) dui aan dat 920 professionele persone betrokke was by arbeidsintensiewe werke aan padinfrastruktuur. 'n Doelgerigte steekproeftegniek is gebruik om 40 distrikte te selekteer wat in padbouprojekte betrokke was; hieruit is 560 respondente oorweeg. Beskrywende en inferensiële statistiek is vir die data-analise gebruik. Hoofasfaktoranalise het ses komponente in die drie arbeidsproduktiwiteitskategorieë met eiewaardes bo 1 aan die lig gebring wat die optimalisering van arbeidsintensiewe produktiwiteit vir konstruksieprojekte in Ghana kan beïnvloed. Dit bestaan uit toerusting en gereedskap, materiaal en temperatuur. Die optimalisering van arbeidsintensiewe produktiwiteit in konstruksiewerke vereis die betrokkenheid van alle belanghebbendes, insluitend projekbestuurders, werkers, verskaffers en subkontrakteurs. Deur die ses komponente in die voorgestelde arbeidsproduktiwiteitsraamwerk te implementeer, kan konstruksieprojekte verhoogde produktiwiteit, kostebesparings en verbeterde uitkomste behaal. Die raamwerk kan beleidmakers in die konstruksiebedryf help om die bestaande nasionale beleid te hersien wat daarop gemik is om inheemse firmas te help om produktiwiteit in die konstruksiebedryf te verbeter.






    1. INTRODUCTION

    The labour-intensive public works (LIPW) programme in Ghana has been designed to facilitate and promote the local economic development agenda through the provision of local employment opportunities and the use of local resources (Bamfo-Agyei, Thwala & Aigbavboa, 2022a: 2). The cardinal principles of labour-intensive public works include equal opportunities for men and women willing to work; equal pay for equal work, emphasising local resource mobilisation, ensuring cost-effectiveness, value for money, quality output, and environmental sustainability (Bamfo-Agyei et al., 2022b: 120).

    Labour-intensive works coverage currently includes 60 district assemblies in Ghana. The selection of beneficiary district assemblies is based on the extent of poverty and deprivation as well as ensuring regional balance. Nearly 71.7% of the beneficiary district assemblies can be found in the Savannah region of the country (GSOP, 2017).

    Bamfo-Agyei et al. (2022b: 3) argued that labour-intensive techniques such as stone pitching, earth compacting, and digging trenches have been applied in various stages of the development process in Ghana during the pre- and post-independence era of construction. Based on the earlier submission in 2016, the government of Ghana designed a labour-intensive public works policy that addresses the following specific issues: Inadequate employable skills; weak institutional training for persons who wish to make a career in the application of labour-intensive techniques; the high cost of public infrastructure, and physical assets produced through capital-intensive methods (GSOP, 2017). Despite the national benefits derived from using labour-intensive methods in the past, the technique could not be sustained because of the absence of national policy and guidelines to regulate and sustain its application, where feasible.

    There is also evidence that Ghanaians' approach to government work is poor, due to cultural orientation inherited from the colonial era when public sector work was perceived as belonging to the 'Whiteman'; hence, this could be handled haphazardly (Damoah & Akwei, 2017: 33). The cultural design poses a significant influence on the Ghanaian government's construction project performance. Partisanship politics could influence the failure of Ghanaian government construction projects (Dick-Sagoe et al., 2023: 2).

    Despite the success of labour-intensive projects in the past, no coordinated policy framework has been implemented/developed to guide and mainstream the application of labour-intensive methods in Ghana's development process. It is, therefore, important to develop a holistic construction labour-intensive productivity framework that would be available to project managers. This will guide and estimate optimal labour productivity as well as evaluate the efficiency of their construction operations. This article determines the factors influencing the optimisation of labour productivity that is needed to develop a framework for estimating the optimal construction labour productivity for labour-intensive work in the Ghanaian construction industry.



    2. LITERATURE REVIEW

    This literature review aims to provide an overview of the key concepts, theories, and practices related to labour-intensive construction work.

    2.1 Labour-intensive construction work

    Labour-intensive construction work is a construction method that relies heavily on manual labour instead of heavy machinery and equipment. It is often used in developing countries, where access to modern technology and equipment is limited. There are several definitions for labour-intensive construction work, each emphasising different aspects.

    According to Nag and Gite (2020: 308), labour-intensive construction work involves the use of "simple hand tools, human muscle power and minimal mechanical equipment to execute construction works". This construction method requires a large number of workers and can involve tasks such as excavation, mixing, transporting of materials, and manual installation of components (Wang et al., 2021: 84).

    The International Labour Organization (ILO) (2020: 5) defined labour-intensive construction work as "a set of techniques which combine labour, local resources and low-cost materials to provide basic infrastructure and services, such as housing, water supply, sanitation, and access roads, particularly in rural and peri-urban areas". This definition emphasises the use of local resources and low-cost materials, in addition to manual labour.

    According to Hilson and Hu (2022: 95), labour-intensive construction work is often associated with small-scale projects such as building homes, schools, and community centres. This definition highlights the focus on community-based projects that aim to improve the quality of life for local communities.

    McCutcheon (2008: 5) defined labour-intensive road construction as the economically efficient employment of as great a proportion of labour as is technically feasible to produce as high a standard of the road as demanded by the specification and allowed by the funding available.

    Thwala (2011: 6014) defined labour-intensive work as the combination of labour and appropriate equipment, which is generally light equipment. Thwala (2011: 6018) indicates that optimal use is made of labour as the predominant resource in infrastructure projects, while ensuring cost-effectiveness and safeguarding quality. It also means ensuring that labour-intensive projects do not degenerate into 'make-work' projects, in which cost and quality aspects are ignored.

    For this article, the definition provided by the ILO, emphasising the use of local resources and low-cost materials in addition to manual labour, is adopted.

    There are six theories related to labour-intensive construction work that need introduction. To explain the development of the proposed labour-productivity optimisation framework only two (the Resource Dependency Theory and the Capability Approach Theory) were adopted.

    The Institutional Theory supports that institutions, or the formal and informal rules that shape social behaviour, play a critical role in shaping economic outcomes (Gao-Zeller et al., 2019: 1942). In the context of labour-intensive construction work, institutions such as labour laws, government regulations, and social norms influence the way in which construction projects are carried out and the outcomes produced.

    The Transaction Cost Theory argues that the cost of transactions between different elements in the market affects the behaviour of firms and their decision-making processes (Govindan, Shaw & Majumdar, 2021: 5). In the context of labour-intensive construction work, transaction costs can be high, due to the complexity of coordinating labour, materials, and financing across multiple elements in the market.

    The Social Learning Theory suggests that people learn from their social environment through observation, imitation, and modelling (Broto & Dewberry, 2016: 3020). This theory can be applied to labour-intensive construction work by encouraging workers to learn from one another through peer-to-peer training, mentorship, and collective problem-solving.

    The Social Capital Theory highlights the importance of social networks, relationships, and trust in promoting economic and social development (Teshome, De Graaff & Kessler, 2016: 220). In the context of labour-intensive construction work, social capital can be developed by building trust between workers, contractors, and local communities, and by involving local communities in the construction process (Clarke & Gholamshahi, 2018: 252).

    The Resource Dependency Theory suggests that organisations depend on external resources to function effectively and efficiently (Govindan et al., 2021: 5). In the context of labour-intensive construction work, organisations depend on the availability of skilled labour, raw materials, and financing to carry out their projects effectively. Without access to skilled labour, construction projects may be delayed, inefficient, and produce poor outcomes. By understanding the resource dependencies of organisations involved in labour-intensive construction work, strategies can be developed to address the challenges they face and to improve the outcomes of construction projects.

    The Capability Approach Theory, developed by economist Amartya Sen (1999), emphasises the importance of human development and individual capabilities, rather than solely focusing on economic growth (Andreoni, Chang & Estevez, 2021: 191). The Capability Approach Theory recognises that each person has a unique set of capabilities, including knowledge, skills, and agency, which are essential for their overall well-being. In the context of labour-intensive construction work, the Capability Approach Theory can be applied by providing workers with opportunities to learn and develop new skills, thus empowering them to take on more responsibility and decision-making roles in the construction process, and recognising the value of their work beyond their economic output. The Capability Approach Theory recognises the value of individual workers and their capabilities. This is important in labour-intensive construction work that relies heavily on manual labour. By empowering workers with the skills and knowledge to take on more responsibility and decision-making roles, workers are more likely to contribute to the overall success of the construction project.

    2.2 Construction labour productivity

    Construction labour productivity is a measure of the efficiency and effectiveness of construction workers in completing their tasks (Manoharan et al., 2023: 144). Productivity is crucial to the success of construction projects, and understanding the factors that impact productivity is essential (Durdyev & Mbachu, 2018: 388). Weng et al. (2020: 2) found that construction labour productivity can be influenced by a wide range of factors, including project management practices, the availability and quality of tools, equipment and materials, worker skills, experience and motivation, work-based conditions, as well as environmental factors. These factors affect the productivity of construction workers and can have a significant impact on project success. The study also found that improving productivity requires a holistic approach that considers all of these factors and that effective project management is crucial to achieving high levels of productivity.

    Management factors refer to the practices and strategies adopted by project managers to optimise productivity. These may affect labour productivity (Bender et al., 2018: 380; Nguyen & Watanabe, 2017: 781). Weng et al. (2020: 3) found that project management practices such as effective communication, coordination, and planning can significantly improve productivity levels. Similarly, Zhang et al. (2018: 298) found that the use of lean construction practices such as just-in-time delivery and waste reduction can improve productivity levels, by reducing waste, improving communication, and increasing efficiency.

    Tools and equipment factors refer to the availability and quality of tools and equipment used in construction projects (Sheikh, Lakshmipath & Prakash, 2016: 5668; Cheng, Tran & Hoang, 2017: 120). Bogue (2018: 4) found that the use of advanced technology such as drones and robotics can improve productivity, by reducing manual labour and increasing accuracy of the project.

    Material factors refer to the availability and quality of materials used in construction projects (Ghanem et al., 2018: 18). Liu and Lu (2018: 3) found that the timely and efficient delivery of materials is essential for maintaining high levels of productivity. Similarly, Liao, Teo and Low (2018: 22) found that the use of Building Information Modeling (BIM) technology can improve material management and reduce waste, leading to increased productivity.

    Worker factors refer to the skills, experience, motivation, as well as physical and mental well-being of construction workers (Dixit et al., 2019: 557; Khosrowpour, Niebles & Golparvar-Fard, 2014: 79). Research has shown that these worker-related factors can significantly impact on productivity. For example, Weng et al. (2020: 2) found that training programmes that improve workers' skills and knowledge can lead to higher productivity rates. Zhang et al. (2018: 300) found that providing workers with a safe and healthy work environment can improve their motivation and overall well-being, leading to increased productivity.

    Work-based conditions, including workspace design, refer to the physical conditions in which construction work takes place (Udris & Nibel, 2017: 79). Wang et al. (2018: 663) found that optimising work-based conditions such as reducing noise and improving lighting can lead to significant increases in productivity.

    Environmental factors such as temperature also play a significant role in construction labour productivity. Li and Lu (2018: 325) found that extreme temperatures can significantly impact on workers' physical and mental well-being, leading to lower productivity rates. Other researchers also concluded that the weather can negatively disrupt the activities of the project (Ghoddousi & Hosseini, 2012: 102; Lessing et al., 2017: 69). Similarly, Chou et al. (2019: 12) found that regulations related to safety and environmental protection can impact on productivity, and that careful planning and management can help mitigate their effects.

    2.3 Optimisation and productivity

    Momade et al. (2022: 1930) explored strategies for optimising construction labour productivity in labour-intensive projects. The study found that effective project planning and scheduling are critical to achieving high levels of productivity. This includes identifying and prioritising critical tasks and allocating resources accordingly. The ability to accomplish deadlines on time and on a budget is the most important skill in optimisation. Strategies such as the fuzzy-based simulation annealing method are used to study the optimisation problem in terms of time and cost (Haque & Hasin, 2016: 1475). The fuzzy-based simulation annealing method works by first defining the problem and identifying the input parameters such as the type of labour-intensive technique used, the number of workers, and the amount of time required to complete the task (Rahmanniyay & Yu, 2019: 233).

    Next, fuzzy logic is used to create a set of rules that represent the relationship between the input parameters and the output, which is the labour-intensive productivity. These rules are based on expert knowledge and experience and are used to make decisions about the optimal combination of input parameters to maximise the output (Tsehayae & Fayek, 2016: 210).

    Simulated annealing is then used to search for the optimal solution within the fuzzy rule-based system. This involves randomly generating a solution and calculating its suitability, which is a measure of how well it meets the objective function. The solution is then subjected to a set of perturbations or changes to explore the search space and find a better solution. This process continues until the optimal solution is found (Rahmanniyay & Yu, 2019: 235).

    The fuzzy-based simulation annealing method has been applied in various construction projects, including road construction, building construction, and infrastructure development. Its advantages include its ability to handle uncertainty and vagueness in the input parameters, and to find the global optimum solution rather than getting trapped in local optima. Its limitations include the need for expert knowledge and experience to create the fuzzy rule-based system and the computational complexity of the simulated annealing algorithm (Haque & Hasin, 2016: 1475).

    Numerous construction-related fields have employed optimisation approaches such as the critical path method, linear programming (Kumar, Wilfred & Sridevi, 2017); non-dominated genetic algorithm (Taheri Amiri et al., 2018: 3745); fuzzy logic with genetic algorithm (Acar Yildirim & Akcay, 2019: 560), and learning curve methods (Abdelkhalek, Refaie & Aziz, 2020: 1075) for managing multiple construction projects simultaneously. Lin and Lai (2020:124) proposed a time-cost trade-off model to reduce project duration that used a genetic algorithm to evaluate productivity.

    Durdyev, Omarov and Ismail (2017: 10) found that communication and coordination among project team members can improve labour-intensive productivity, which can be facilitated by using tools such as project management software. Providing workers with appropriate training and support is another strategy for optimising labour-intensive productivity in projects. Hewitt et al. (2015:948) presented a model that allocates assignments to workers with various ability levels, using mixed-integer non-linear programming.

    For optimising work-based conditions, Jin et al. (2020: 635) suggested a multi-objective workspace-based optimisation approach to generate the most effective scaffolding resource allocation and space-planning decisions.



    3. RESEARCH METHODOLOGY

    3.1 Research design

    Factors affecting the labour productivity of labour-intensive works were investigated using a quantitative research design, with data being collected through a questionnaire-based descriptive survey. Quantitative surveys collect data that can be analysed to reveal trends, averages, and frequencies (Bless, Higson-Smith & Sithole, 2018: 16; Fellows & Liu, 2008: 222; Dixon et al., 2020: 742). A quantitative design allows researchers to extrapolate their results to a larger population (Creswell, 2014: 11; Bryman, 2016: 232; Newman, 2020:648). In the survey, 26 factors were chosen as the benchmarks that would evaluate labour-intensive productivity. In order to distil a large number of measured variables into a manageable set, Principal Component Analysis (PCA) was used. According to Rossoni et al. (2016: 201), PCA can be used to extract factors, which can be used to summarise the data into a manageable number of factors based on the highest eigenvalues. The framework for optimising labour productivity was developed with the aid of regression analysis.

    3.2 Population, sampling, and response rate

    Contractors, site engineers, facilitators, timekeepers, district engineers, and GSOP desk officers in Ghana, who are engaged in heavy labour-intensive construction work, form the population for this study. According to data collected by the GSOP, 920 professionals engaged in manual labour activities were eligible for inclusion in the study. The GSOP has regional offices in Bolgatanga, Wa, Temale, Kumasi, and Accra. An equitable distribution of survey responses across the various administrative regions was achieved, using a stratified sample technique, due to the demographic variety of the country's population. Bolgatanga has 12 district offices; Wa has 10; Temale has 11; Kumasi has 14, and Accra has 13 district offices, totalling 60 district offices for all the zonal offices.

    Due to the fact that not all districts were involved in heavy labour-intensive construction projects, 40 districts were chosen, using the purposive sampling method. Specifically, one district engineer and one GSOP desk officer were chosen at random from each of the 40 districts, resulting in a total of 80 respondents. Three locations were selected from each of the 40 districts, totalling 120 sites. Each of the 120 sites had one facilitator, one timekeeper, one site engineer, and one contractor. The investigation comprised a total of 560 individuals, of whom only 543 returned valid responses, resulting in a 97% response rate. Krejcie and Morgan's (1970: 608) table suggests a sample size of 175 for a population of 950. For a total population of 920, this recommendation verifies that a sample size of 560 is sufficient.

    3.3 Data collection

    From November 2016 to August 2017, 560 questionnaires were distributed through drop-and-collect and e-mailed to potential respondents who perform heavy labour-intensive work on construction projects in Ghana. The researchers compiled a questionnaire consisting of two sections. The first section contains questions on the demographic data of the respondents, including age, gender, occupation, level of education, years of experience, and region. Taken from reviews of the relevant literature, the second section set 26 statements on the construct 'factors critical for labour productivity' in three categories, namely 'Equipment and tools', 'Materials', and 'Temperature'. Using a 5-point Likert scale, respondents were asked to rate the importance of these statements in optimising the productivity of firms in Ghana that rely heavily on manual labour. The items used on the Likert scale for the descriptive analysis and the variables for the inferential statistics that examined the validity and reliability of the factors were derived from these measurements. Section two's closed-ended questions were favoured to reduce respondent bias (Harlacher, 2016: 9-10). Cronbach's alpha was calculated in accordance with Taber (2018: 1273) to assess the items' internal consistency. It has been established that values between 0.70 and 0.95 for Cronbach's alpha are considered adequate (Tavakol & Dennick, 2011: 54-55); hence, a threshold of 0.70 was used in this study.

    3.4 Method of analysis and interpretation of the data

    All of the tabular and graphical displays are the results of an SPSS 24.0 analysis of the data (Pallant, 2013: 134). Descriptive statistics were used to analyse the respondents' demographics. Frequencies and percentages were calculated and reported.

    Using a five-point Likert scale, the 26 items that could optimise the performance of labour productivity were ranked, based on mean scores. Opinions can be measured with the help of Likert-type or rating scales that use fixed choice response formats (Singh, 2006: 202). Mean scores were measured, using a scale where 1 = Very poor (>1.00 and <1.80); 2 = Poor (>1.81 and <2.60); 3 = Good (>2.61 and <3.40); 4 = Very good (>3.41 and <4.20), and 5 = Excellent (>4.21 and <5.00).

    Data appropriateness for factor analysis was validated, using the Meyer-Olkin (KMO) (Lorenzo-Seva, Timmerman & Kiers, 2011) and the Bartlett's Test of Sphericity (Hair et al., 2014: 110). Considering that the KMO test scores can be anywhere from 0 to 1, it was determined that EFA could only be used if the values were greater than 0.7 (Hair et al., 2014). In order to proceed with the study, the variables must show sufficient correlation, as indicated by a statistically significant Bartlett test (p=0.05) (Pallant, 2013: 190). This study adopted the assertion made by Hair et al.'s (2014) assertion in selecting eigenvalues criterion to determine the maximum number of factors to retain in the model.

    Using a PCA criterion of initial eigenvalues greater than 1, the Oblimin rotation with Kaiser normalisation and factor loading of 0.4 was considered to be good, as it had 30% overlapping variance (Rossoni, Engelbert & Bellegard, 2016: 102). A range from 0.2 to 0.4 is the optimal inter-item correlations mean (factor loading) for the factor to be reliable (Pallant, 2013: 134).



    4. FINDINGS

    4.1 Demographic profile of the respondents

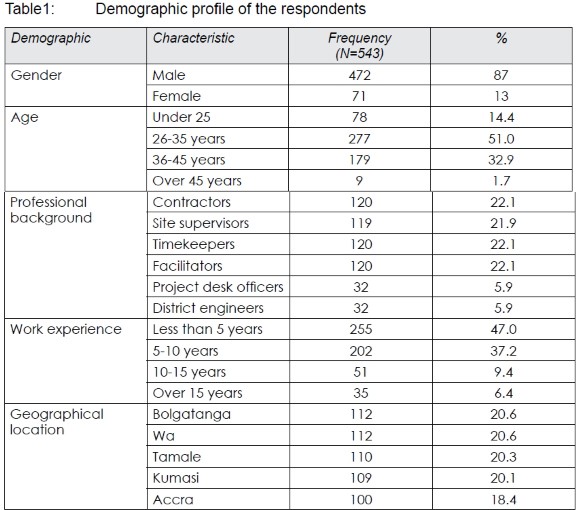

    Table 1 shows that the majority of the respondents (87%) are male, aged between 26 and 35 (51.1%) years. Most of the respondents are almost equally employed as contractors, timekeepers, and facilitators (22.1%) each, and supervisors (21.9%). Over half of the participants have post-secondary education, with the majority of them (66.6%) holding either a bachelor's degree (36%) or a technical certificate (30.6%), and the remaining 16.9% having completed high school.





    While nearly half of the respondents (47%) have two to five years' experience, just over half (53.1%) have six years' experience or more. This shows that the respondents have the necessary skills and expertise to provide data that could be used to draw conclusions about parameters optimising labour-intensive productivity. The geographic distribution of respondents was nearly even: 20.6% were from Bolgatanga; 20.6% from Wa; 20.3% from Tamale, 20.1% from Kumasi, and 18.4% from Accra. However, the majority of the respondents (61.5%) are employed in the three northern regions of Ghana: Bolgatanga, Wa, and Tamale.

    4.2 Ranking of productivity factors

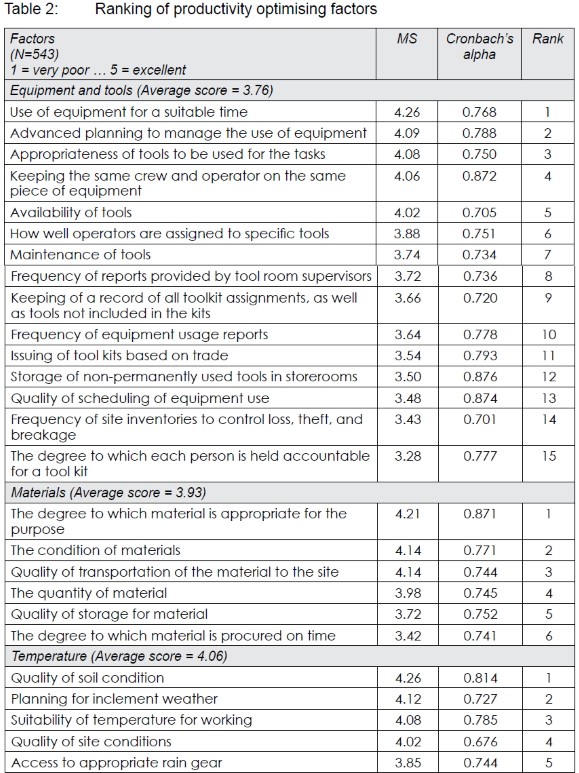

    In Table 2, average MS of 3.76, 3.93, and 4.09, respectively, for the three productivity optimising categories shows that respondents rated all 26 factors as good to have an influence on the optimisation of labour-intensive productivity of the firms involved in heavy labour-intensive construction works in Ghana. With MS above 4.20 'Use of equipment for a suitable time' (MS=4.26), 'The degree to which material is appropriate for the purpose' (MS=4.21), and 'Quality of soil condition' (MS=4.26) were rated the top three and perceived by respondents as excellent factors that influence the optimising of productivity in heavy labour-intensive construction work. The Cronbach's alpha values for each factor were greater than 0.70, indicating acceptable internal reliability, as recommended by Hair et al. (2014).





    In the category 'Equipment and tools', with mean score ratings above 4, 'Use of equipment for suitable time' (MS=4.26), 'Advanced planning to manage the use of equipment' (MS=4.09), 'Appropriateness of tools to be used for the tasks' (MS=4.08), 'Keeping the same crew and operator on the same piece of equipment' (MS=4.06), and 'Availability of tools' (MS=4.02) were ranked the top five factors that influence optimisation of the performance of labour productivity in heavy labour-intensive construction work.

    The factors 'Degree to which material is appropriate for purpose' (MS=2.21), 'The condition of materials' (MS=4.14), and 'Quality of transportation of the material to the site' (MS=4.14) were ranked the top three factors that have an influence on optimising productivity in the 'Materials' category for heavy labour-intensive construction work.

    In the category 'Temperature', with mean score ratings above 4, 'Quality of soil condition' (MS=4.26), 'Planning for inclement weather' (MS= 4.12), and 'Suitability of temperature for working' (MS= 4.08) were ranked the top three factors influencing optimisation of the labour productivity performance in heavy labour-intensive construction work.

    4.3 Principal component analysis

    The 26 factors in the three categories that have an influence on optimising labour productivity of labour-intensive construction work were subjected to PCA to assess their validity and reliability. The results report the suitability of the data to be analysed, factor extraction and rotation, and interpretation.

    4.3.1 Equipment and tools category

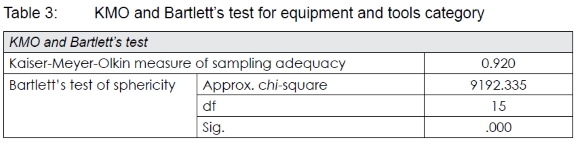

    As shown in Table 3, the KMO measure of sampling adequacy achieved a value of 0.920, exceeding the recommended minimum value of 0.7. Bartlett's test of sphericity was also statistically significant (p<0.05), thus supporting the factorability of the correlation matrix for the equipment and tools component.

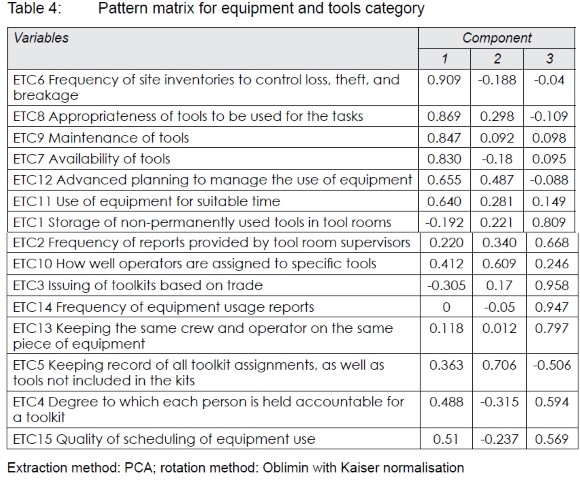

    The pattern matrix in Table 4 shows that, out of the initial 15 variables, PCA extracted 15 variables in three components with factor loadings above 0.4, with the potential to influence the optimisation of labour productivity of heavy labour-intensive construction work in Ghana.

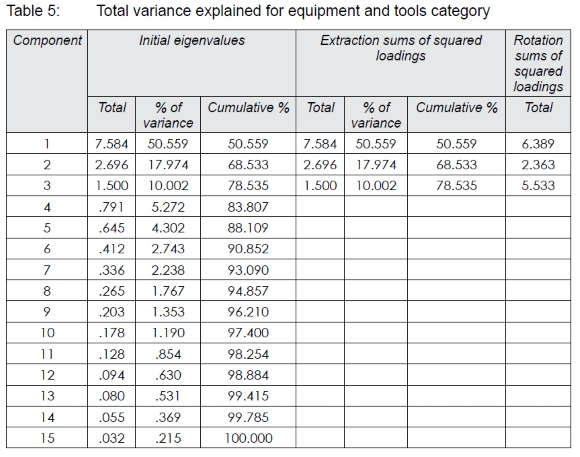

    Table 5 shows that, after rotation, three components, with eigenvalues exceeding 1.0, were extracted and are meaningful to retain. Factor one explains 50.56% of the total variance; factor two, 17.97%, and factor three, 10.00%. Thus, the final statistics of the PCA shows that three extracted factors explain a cumulative variance of approximately 78.53%.

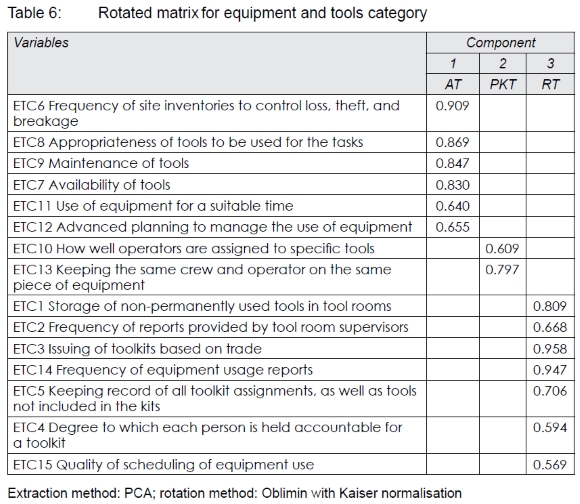

    Table 6 reveals the correlation of variables based on their factor loadings after rotation in PCA. Three principal components with eigenvalues above 1 (see Table 5) were examined on the inherent relationships among the variables. Variables with the highest loadings (values of 0.4 and above) in a component are most strongly correlated with that component. Component 1 was labelled Appropriate tools (AT); Component 2, Participants' knowledge of tools (PKT), and Component 3, Recording of tools (RT). The names given were derived from a close examination of the variables within each of the components.





    Component 1 Appropriate tools explained 50.6% of the total variance and have six correlated variable loadings, frequency of site inventories to control loss, theft, and breakage (0.909), appropriateness of tools to be used for the tasks (0.869), maintenance of tools (0.847), availability of tools (0.830), use of equipment for a suitable time (0.640), and advanced planning to manage the use of equipment (0.655).

    Component 2 Participants' knowledge of tools explained 18% of the total variance and had two variable loadings, how well operators are assigned to specific tools (0.509), and keeping the same crew and operator on the same piece of equipment (0.797).

    Component 3: Recording of tools, explained 10% of the variance and had seven variable loadings, storage of non-permanently used tools in tool rooms (0.809), frequency of reports provided by tool room supervisors (0.668), issuing of toolkits based on trade (0.958), frequency of equipment usage reports (0.947), keeping record of all toolkit assignments, as well as tools not included in the kits (0.706), degree to which each person is held accountable for toolkit (0.594), and quality of scheduling of equipment use (0.569).

    4.3.2 Material category

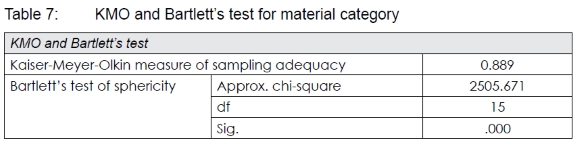

    Table 7 reveals that the KMO measure of sampling adequacy achieved a value of 0.889, exceeding the recommended minimum value of 0.7. Bartlett's test of sphericity was also statistically significant (p<0.05), supporting that the data is suitable for factor analysis.

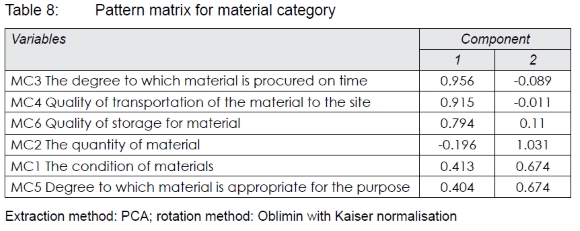

    The pattern matrix from the PCA in Table 8 shows all 6 initial variables, in two components with factor loadings above 0.4 with the potential to influence labour productivity optimisation of heavy labour-intensive construction work in Ghana.

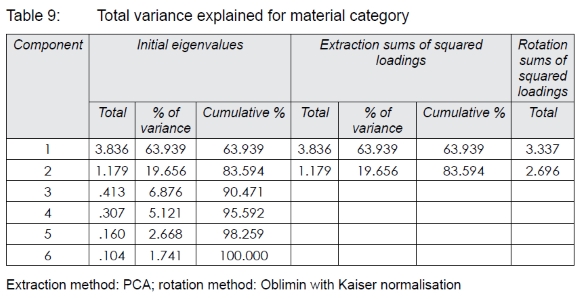

    Table 9 shows that, after rotation, two components with eigenvalues exceeding 1.0 cumulatively explained approximately 83.59% of the total variations and should retain. Component one explains 63.94% of the total variance and factor two, 19.66%.

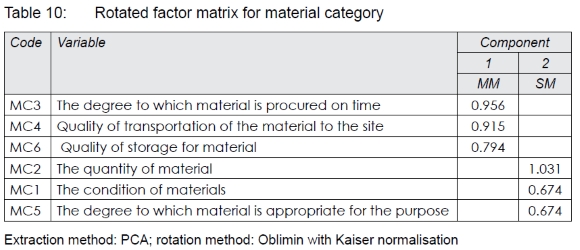

    Table 10 reveals the correlation of variables based on their loadings after rotation in PCA. Two components with eigenvalues above 1 (see Table 4) were examined on the inherent relationships among the variables. Variables with the highest loadings (values of 0.4 and above) in one component are most strongly correlated with that component. Component 1 was labelled Management of material (MM), and Component 2 Suitability of material (SM). The names given were derived from a close examination of the variables within each of the components.





    Component 1: Management of material, explained 63.9% of the total variance and had three correlated variable loadings, the degree to which material is procured on time is estimated (0.956), quality of transportation of the material to the site (0.915), and quality of storage for material (0.794).

    Component 2: Suitability of material, had three correlated variable loadings, quantity of material (1.031), condition of materials (0.674), degree to which material is appropriate for the purpose (0.674), and accounted for 19.7% of the total variance.

    4.3.3 Temperature category

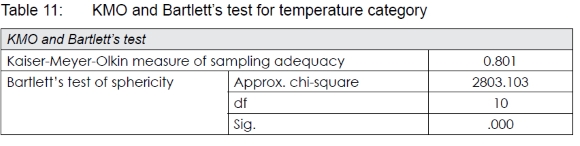

    The KMO measure of sampling adequacy achieved a value of 0.801, exceeding the recommended minimum value of 0.7. Bartlett's test of sphericity was also statistically significant (p<0.05), supporting that the data is suitable for factor analysis.

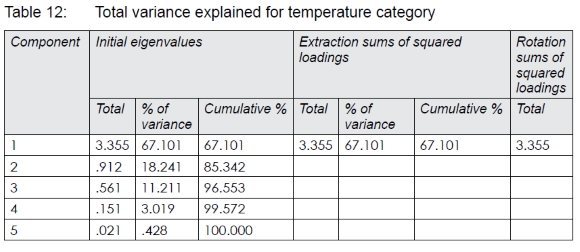

    Table 12 shows that, after rotation, one component with eigenvalues exceeding 1.0 was extracted. This component explains 67.10% of the total variance and is meaningful to retain.

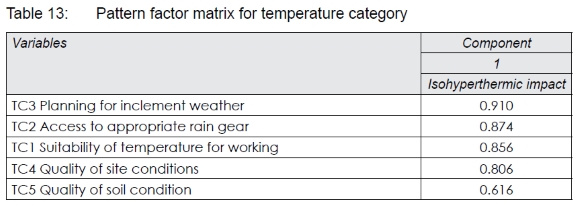

    The pattern matrix in Table 13 shows that, out of the initial 5 variables, PCA extracted 5 variables in one component with factor loadings above 0.4, with the potential to influence optimisation of labour productivity in heavy labour-intensive construction in Ghana.





    Based on the examination of the inherent relationships among the variables, Component 1 was termed isohyperthermic impact and explained 67.1% of the variance. Component 1 had five correlated variable loadings, planning for inclement weather is estimated (0.91), access to appropriate rain gear (0.874), suitability of temperature for working (0.856), quality of site conditions (0.806), and quality of soil condition (0.616).



    5. PROPOSED LABOUR PRODUCTIVITY OPTIMISATION FRAMEWORK

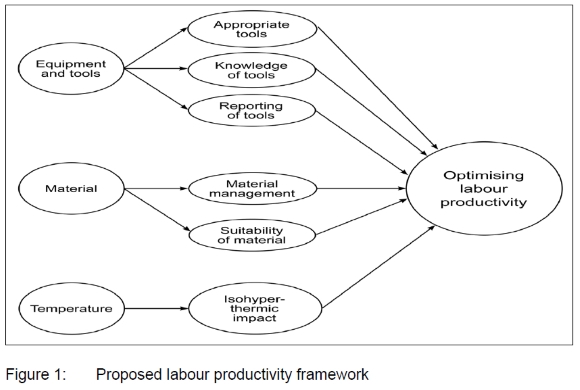

    The productivity of public works that rely heavily on human labour can now be evaluated using frameworks developed from studies of labour productivity that take into account both objective and subjective factors. Figure 1 shows a proposed framework that could optimise labour productivity for heavy labour-intensive construction work. The six components derived from the three labour-optimisation categories in this article form the elements included in the framework.





    5.1 Equipment and tools

    Three main factors were identified to influence the equipment and tools category in optimising labour productivity of heavy labour-intensive construction work. These included appropriate tools, participants' knowledge of tools, and recording of tools that influenced labour productivity.

    Appropriate tools play a crucial role in increasing efficiency and reducing the time required for a task. As stated by Yeom et al. (2022: 5), the use of advanced and appropriate tools such as cranes, bulldozers, and excavators helped improve labour productivity in the construction industry. Rane, Potdar and Rane (2021: 1470) emphasised that construction companies need to establish a systematic approach to inventory management, including implementing inventory tracking systems, conducting frequent inspections, and implementing security measures to minimise losses. Construction companies should establish maintenance schedules and protocols to inspect, clean, repair, and replace tools as needed. The service and maintenance of tools that need to be fixed could help avoid incidents or accidents, due to faulty equipment and tools on projects (Bamfo-Agyei et al. (2022c: 12). Construction companies should carefully plan and schedule the use of equipment, considering factors such as project timelines, task dependencies, and equipment availability. They should engage in comprehensive project planning, considering factors such as equipment requirements, task sequencing, and resource allocation. This can provide guidance on equipment-scheduling techniques, resource-allocation models, and project-planning methodologies to optimise equipment usage.

    Even if appropriate tools are available, if the workers lack knowledge of how to use them correctly, their effectiveness may be reduced. Zhang et al. (2020: 6) argued that enhancing workers' knowledge, workers can work more efficiently, avoid mistakes, and make informed decisions regarding tool selection and operation. Assigning operators to tools based on their skills, experience, and familiarity with the task requirements can optimise productivity. By keeping the same crew and operator on the same piece of equipment, construction companies can reduce the time needed for adaptation, enhance operational efficiency, minimise errors, and promote effective teamwork (Li, Teng & Yuan, 2018: 160).

    Construction companies should establish efficient systems for tool management and storage. Tsai et al. (2020: 15) suggested that accurate tool recording when implemented in construction projects will ensure that equipment is available when needed. Accountability for toolkits means that the industry should establish clear protocols and expectations regarding the responsibility of individuals for the tools assigned to them (Albert, Shakantu & Ibrahim, 2021: 152). This can provide guidance on tool-tracking systems, inventory-management practices, and tool-room organisation to optimise labour-intensive productivity. By properly recording and storing tools, companies can ensure easy access, minimise loss or theft, and improve overall efficiency on construction sites. In addition, it can offer insights into accountability frameworks, tool check-out/check-in procedures, and performance-evaluation mechanisms that need to be carried out at the site.

    Reporting mechanisms, communication channels, and reporting intervals to ensure effective information flow between tool-room supervisors and project teams is important. Timely and accurate reports can aid in decision-making and proactive management of tools.

    5.2 Material

    Materials management and material appropriateness are two elements that can improve the efficiency of labour in labour-intensive projects. According to Liu and Lu (2018: 325), the use of effective material-management systems helps ensure that materials are available when needed, thus increasing productivity in the construction industry. Material management provides insights into inventory-management techniques, procurement strategies, and forecasting methods to optimise the availability of materials. Proper management of material involves accurately estimating the required quantities of materials for construction projects. It helps reduce waste and delays, by making sure that the appropriate resources are accessible at the right time and in the right quantity (Liu, Yi & Wang, 2020). Timely procurement is crucial to avoid delays, disruptions, and additional costs (Omopariola et al., 2020: 312). Efficient transportation of materials to the construction site ensures that the materials are delivered on time and in good condition. Appropriate storage facilities and practices are essential to preserve the quality and integrity of materials. By adhering to best practices for material storage, construction industries can minimise material damage, improve inventory control, and streamline access to materials, thus leading to increased labour-intensive productivity.

    The suitability of materials used can also impact on labour productivity. Santos et al. (2019: 135) emphasised that the construction industry needs to carefully assess and determine the appropriate quantity of materials required for each project phase. Pornthepkasemsant and Charoenpornpattana (2019: 852) stated that using high-quality materials can reduce maintenance time and increase productivity. Making use of quality management and material inspection can offer insights into best practices for quality control, quality assurance, and material testing. Implementing these quality practices ensures that the right amount of materials is available, thus minimising waste, reducing costs, avoiding rework and delays (Sibande & Agumba, 2018: 525), and enhancing labour-intensive productivity (Hasan et al., 2018: 920). Material selection, specifications, and performance criteria can provide guidance on identifying suitable materials for various construction tasks.

    5.3 Temperature

    In the construction industry, measures should be taken to ensure that workers work in a comfortable environment, which increases productivity. Morris et al. (2021: 292) emphasised the importance of proactive planning for inclement weather conditions in construction projects. This implies that construction companies should consider potential weather disruptions and incorporate contingency plans into their project scheduling and management. Weather-risk management and construction-project planning can provide insights into strategies for weather forecasting, scheduling adjustments, and resource allocation to mitigate the impact of adverse weather conditions.

    Construction companies can enable workers to continue working efficiently, even during inclement weather, by providing suitable rain gear and implementing safety protocols on sites.

    Temperature and humidity levels can also impact on labour productivity, as stated by Bamfo-Agyei et al. (2021: 170); the isohyperthermic impact on workers can reduce efficiency and increase the risk of heat-related illnesses. Mahyuddin et al. (2022: 40) argued that the workforce functions most efficiently at an ambient temperature of 15°C to 22°C, with moderate 40% to 70% humidity. Management should consider the expected daily temperatures when deciding when to begin the project or when to carry it out, in order to maximise the efficiency of their workforce.

    Several reports have mentioned how poor weather can lead to disruptions, damage, and subsequent delays in projects (Hurlimann, Warren-Myers & Browne, 2019: 130; Zhao et al., 2022: 1760). Construction sites should be properly prepared, organised, and maintained to facilitate efficient workflow and minimise disruptions.

    Dhakal and Kattel (2019: 670) claimed that soil properties such as stability, compaction, and drainage can significantly influence construction activities. Because of the low quality of the soil, the workers would need extra time to complete a given task. Considering soil conditions and implementing suitable soil-management practices, construction companies can optimise labour-intensive productivity by minimising delays, improving excavation and foundation works, and ensuring stable and safe construction processes.



    6. CONCLUSION AND RECOMMENDATION

    Construction labour productivity is a complex and multifaceted issue that requires a comprehensive understanding of the factors that impact on productivity. In order to maximise labour productivity in the construction industry, a comprehensive strategy that takes into account a variety of productivity-affecting elements is necessary. These factors include worker skills and motivation, project-management techniques, work base conditions, as well as the availability and quality of materials and tools. The proposed labour productivity optimisation framework contains elements of how these factors can be effectively implemented to increase productivity. The six critical components that need to be considered are appropriate tools, workers' knowledge of tools, recording of tools, material management, suitability of material, and isohyperthermic impact. It can be concluded that the six-component framework represents an adequate description of labour productivity optimisation for heavy labour-intensive public construction work in Ghana. By incorporating these components, construction projects can be completed more efficiently, resulting in cost savings and improved project completion time.

    Optimising labour productivity in Ghanian construction works requires the involvement of all stakeholders, including project managers, workers, suppliers, and subcontractors. In practice, labour-intensive construction work often involves the use of participatory approaches, which involve local communities in Ghana for the decision-making process and the implementation of construction projects.

    Implementation and use of the proposed framework relies on the willingness of contractors or owners of construction firms relative to understand the importance of such a framework. It is, therefore, recommended that the interrelated 'tools', 'materials' and 'isohyperthermic impact' included in the framework are of utmost importance. These include engaging skilled workers, or organsations that proffer the encouragement of contractors or owners of construction firms to take ownership in an attempt to introduce and implement this proposed labour productivity optimisation framework to their firms. It could guide contractors to ensure that all elements necessary for achieving high labour productivity of construction firms are in place and help them make decisions that impact on the labour productivity of their firms.

    The framework may help the Ghana Social Opportunity project, which supervises the implementation of labour-intensive public, in providing relevant training programmes that aim at developing the capacity of indigenous firms to enhance their productivity. The framework may help policymakers in the construction industry to review the existing national policies that are geared towards helping indigenous firms improve productivity in the construction industry.

    Optimising labour productivity in construction works is a continuous process that requires ongoing monitoring, evaluation, and improvement. By prioritising productivity and implementing best practices, construction projects can be completed more efficiently, resulting in cost savings and improved outcomes.

    This article does not consider the framework as a complete resolve to the plight of the labour-intensive methods in the construction industry and the relationship to good productivity. Further research is needed to improve the framework developed in this article and possibly refine indicator variables to suit specific environments. Further research is also needed, in order to develop an instrument to measure the level of contractors or owners of construction firm's productivity, specifically for heavy labour-intensive construction work, to optimise their productivity.



    REFERENCES

    Abdelkhalek, H.A., Refaie, H.S. & Aziz, R.F. 2020. Optimization of time and cost through learning curve analysis. Ain Shams Engineering Journal, 11(4), pp. 1069-1082. https://doi.org/10.1016/j.asej.2019.12.007        [ Links ]

    Acar Yildirim, H. & Akcay, C. 2019. Time-cost optimization model proposal for construction projects with genetic algorithm and fuzzy logic approach. Revista de la Construcción, 18(3), pp. 554-567. https://doi.org/10.7764/RDLC.18.3.554        [ Links ]

    Albert, I., Shakantu, W. & Ibrahim, S. 2021. The effect of poor materials management in the construction industry: A case study of Abuja, Nigeria. Acta Structilia, 28(1), pp. 142-167. https://doi.org/10.18820/24150487/as28i1.6        [ Links ]

    Andreoni, A., Chang, H.J. & Estevez, I. 2021. The missing dimensions of the human capabilities approach: Collective and productive. The European Journal of Development Research, 33(2), pp. 179-205. https://doi.org/10.1057/s41287-020-00356-y        [ Links ]

    Bamfo-Agyei, E., Aigbavboa, C. & Thwala, W.D. 2021. Isohyperthermic temperature regime on productivity of labour-intensive works on construction in Ghana. In: Mojekwu, J.N., Thwala, W.D., Aigbavboa, C., Atepor, L. & Sackey, S. (Eds). Sustainable education and development. Springer International Publishing, pp. 164-172. https://doi.org/10.1007/978-3-030-68836-3_15        [ Links ]

    Bamfo-Agyei, E., Aigbavboa, C. & Thwala, W.D. 2022a. Measuring productivity of labour-intensive work practices in road construction in Africa. London, UK: Routledge. https://doi.org/10.1201/9781003282204        [ Links ]

    Bamfo-Agyei, E., Thwala, D.W. & Aigbavboa, C. 2022b. Performance improvement of construction workers to achieve better productivity for labour-intensive works. Buildings, 12(10), article number 1593, pp. 1-18. https://doi.org/10.3390/buildings12101593        [ Links ]

    Bamfo-Agyei, E., Thwala, D.W. & Aigbavboa, C. 2022c. The effect of management control on labour productivity of labour-intensive works in Ghana. Acta Structilia, 29(1), pp. 1-25. https://doi.org/10.18820/24150487/as29i1.1        [ Links ]

    Bender, S., Bloom, N., Card, D., Van Reenen, J. & Wolter, S. 2018. Management practices, workforce selection, and productivity. Journal of Labor Economics, 36(S1), pp. S371-S409. https://doi.org/10.1086/694107        [ Links ]

    Bless, C., Higson-Smith, C. & Sithole, S. 2018. Fundamentals of social research methods: An African perspective. 8th edition. Cape Town: Juta.         [ Links ]

    Bogue, R. 2018. What are the prospects for robots in the construction industry? Industrial Robot: An International Journal, 45(1), pp. 1-6. https://doi.org/10.1108/IR-11-2017-0194        [ Links ]

    Broto, V.C. & Dewberry, E. 2016. Economic crisis and social learning for the provision of public services in two Spanish municipalities. Journal of Cleaner Production, 112(4), pp. 3018-3027. https://doi.org/10.1016/j.jclepro.2015.09.136        [ Links ]

    Bryman, A. 2016. Social research methods. London, UK: Oxford University Press.         [ Links ]

    Cheng, M.Y., Tran, D.H. & Hoang, N.D. 2017. Fuzzy clustering chaotic-based differential evolution for resource levelling in construction projects. Journal of Civil Engineering and Management, 23(1), pp. 113-124. https://doi.org/10.3846/13923730.2014.982699        [ Links ]

    Chou, J., Xian, T., Zhao, R., Xu, Y., Yang, F. & Sun, M. 2019. Drought risk assessment and estimation in vulnerable eco-regions of China: Under the background of climate change. Sustainability, 11(16), pp. 2-14. https://doi.org/10.3390/su11164463        [ Links ]

    Clarke, T. & Gholamshahi, S. 2018. Developing human capital for knowledge based economies. In: Clarke, T. (Ed.). Innovation in the Asia Pacific: From manufacturing to the knowledge economy. Singapore: Springer, pp. 247-270. https://doi.org/10.1007/978-981-10-5895-0_12        [ Links ]

    Creswell, J. W. 2014. Research design: Qualitative, quantitative and mixed methods approaches. 4th edition. Thousand Oaks, CA: Sage.         [ Links ]

    Damoah, I.S. & Akwei, C. 2017. Government project failure in Ghana: A multidimensional approach. International Journal of Managing Projects in Business, 10(1), pp. 32-59. https://doi.org/10.1108/IJMPB-02-2016-0017        [ Links ]

    Dhakal, B. & Kattel, R.R. 2019. Effects of global changes on ecosystems services of multiple natural resources in mountain agricultural landscapes. Science of the Total Environment, 676(1), pp. 665-682. https://doi.org/10.1016/j.scitotenv.2019.04.276        [ Links ]

    Dick-Sagoe, C., Lee, K.Y., Odoom, D. & Boateng, P.O. 2023. Stakeholder perceptions on causes and effects of public project failures in Ghana. Humanities and Social Sciences Communications, 10(1), pp. 1-9. https://doi.org/10.1057/s41599-022-01497-7        [ Links ]

    Dixit, S., Mandal, S.N., Thanikal, J.V. & Saurabh, K. 2019. Evolution of studies in construction productivity: A systematic literature review (2006-2017). Ain Shams Engineering Journal, 10(3), pp. 555-564. https://doi.org/10.1016/j.asej.2018.10.010        [ Links ]

    Dixon, C., Edwards, D.J., Mateo-Garcia, M., Lai, J., Thwala, W.D.D. & Shelbourn, M. 2020. An investigation into the erroneous access and egress behaviours of building users and their impact upon building performance. Facilities, 38(9/10), pp. 739-760. https://doi.org/10.1108/F-05-2019-0053        [ Links ]

    Durdyev, S. & Mbachu, J. 2018. Key constraints to labour productivity in residential building projects: Evidence from Cambodia. International Journal of Construction Management, 18(5), pp. 385-393. https://doi.org/10.1080/15623599.2017.1326301        [ Links ]

    Durdyev, S., Omarov, M. & Ismail, S. 2017. Causes of delay in residential construction projects in Cambodia. Cogent Engineering, 4(1), pp. 2-12. https://doi.org/10.1080/23311916.2017.1291117        [ Links ]

    Fellows, R. & Liu, A. 2008. Impact of participants' values on construction sustainability. In: Proceedings of the Institution of Civil Engineers-Engineering Sustainability 161(4), pp. 219-227. https://doi.org/10.1680/ensu.2008.161.4.219        [ Links ]

    Gao-Zeller, X., Li, X., Yang, F. & Zhu, W. 2019. Driving mechanism of CSR strategy in Chinese construction companies based on neo-institutional theory. KSCE Journal of Civil Engineering, 23, pp. 1939-1951. https://doi.org/10.1007/s12205-019-0989-y        [ Links ]

    Ghanem, M., Hamzeh, F., Seppänen, O. & Zankoul, E. 2018. A new perspective of construction logistics and production control: An exploratory study. In: Proceedings of the 26th Annual Conference of the International Group for Lean Construction (IGLC), Chennai, India, 16-22 July, Chennai, India, pp. 992-1001. https://doi.org/10.24928/2018/0540        [ Links ]

    Ghoddousi, P. & Hosseini, M.R. 2012. A survey of the factors affecting the productivity of construction projects in Iran. Technological and Economic Development of Economy, 18(1), pp. 99-116. https://doi.org/10.3846/20294913.2012.661203        [ Links ]

    Govindan, K., Shaw, M. & Majumdar, A. 2021. Social sustainability tensions in multi-tier supply chain: A systematic literature review towards conceptual framework development. Journal of Cleaner Production, 279, article number 123075, pp. 1-22. https://doi.org/10.1016/j.jclepro.2020.123075        [ Links ]

    GSOP (Ghana Social Opportunities Project). 2017. Labour intensive public works in Ghana. Ministry of Employment.         [ Links ]

    Hair, J.F., Ringle, C.M. & Sarstedt, M. 2013. Partial least squares structural equation modeling: Rigorous applications, better results and higher acceptance. Long Range Planning, 46(1-2), pp. 1-12. https://doi.org/10.1016/j.lrp.2013.01.001        [ Links ]

    Hair, J.F., Black, W.C., Babin, B.J. & Anderson, R.E. 2014. Multivariate data analysis. 7th edition. Upper Saddle River: Pearson Education.         [ Links ]

    Haque, K.M.A. & Hasin, M.A.A. 2016. Fuzzy based project time-cost optimization using simulated annealing search technique. In: Civil and environmental engineering: Concepts, methodologies, tools, and applications. Hershey, USA: IGI Global, pp. 1473-1486. https://doi.org/10.4018/978-1-4666-9619-8.ch067        [ Links ]

    Harlacher, J. 2016. An educator's guide to questionnaire development (REL 2016-108). Washington, DC: U.S. Department of Education.         [ Links ]

    Hasan, A., Baroudi, B., Elmualim, A. & Rameezdeen, R. 2018. Factors affecting construction productivity: A 30-year systematic review. Engineering, Construction and Architectural Management, 25(7), pp. 916-937. https://doi.org/10.1108/ECAM-02-2017-0035        [ Links ]

    Hewitt, M., Chacosky, A., Grasman, S.E. & Thomas, B.W. 2015. Integer programming techniques for solving non-linear workforce planning models with learning. European Journal of Operational Research, 242(3), pp. 942-950. https://doi.org/10.1016/j.ejor.2014.10.060        [ Links ]

    Hilson, G. & Hu, Y. 2022. Changing priorities, shifting narratives: Remapping rural livelihoods in Africa's artisanal and small-scale mining sector. Journal of Rural Studies, 92(3), pp. 93-108. https://doi.org/10.1016/j.jrurstud.2022.03.010        [ Links ]

    Hurlimann, A.C., Warren-Myers, G. & Browne, G.R. 2019. Is the Australian construction industry prepared for climate change? Building and Environment, 153(1), pp. 128-137. https://doi.org/10.1016/j.buildenv.2019.02.008        [ Links ]

    ILO (International Labour Organization). 2020. Labour-intensive infrastructure: An operational framework. Geneva: International Labour Organization.         [ Links ]

    Jin, H., Nahangi, M., Goodrum, P.M. & Yuan, Y. 2020. Multi-objective optimization for scaffolding space planning in industrial piping construction using model-based simulation programming. Journal of Computing in Civil Engineering, 34(1), article number 06019001. https://doi.org/10.1061/(ASCE)CP. 1943-5487.0000861        [ Links ]

    Khosrowpour, A., Niebles, J.C. & Golparvar-Fard, M. 2014. Vision-based workforce assessment using depth images for activity analysis of interior construction operations. Automation in Construction, 48, pp. 74-87. https://doi.org/10.1016/j.autcon.2014.08.003        [ Links ]

    Krejcie, R.V. & Morgan, D.W. 1970. Determining sample size for research activities. Educational and Psychological Measurement, 30, pp. 607-610. https://doi.org/10.1177/001316447003000308        [ Links ]

    Kumar, V.M., Wilfred, A. & Sridevi, H. 2017. Comparative study of time-cost optimization. International Journal of Civil Engineering and Technology, 8(4), pp. 659-663.         [ Links ]

    Lessing, B. & Thurnell, D. & Durdyev, S. 2017. Main factors causing delays in large construction projects: Evidence from New Zealand. Journal of Management, Economics and Industrial Organization, 1(2), pp. 63-82. 10.31039/jomeino.2017.1.2.5.         [ Links ]

    Li, Y., Teng, Y. & Yuan, Y. 2018. An investigation of the effect of weather factors on construction labor productivity. Journal of Cleaner Production, 201, pp. 319-327. DOI: 10.1016/j.jclepro.2018.08.044        [ Links ]

    Li, X., Yi, W., Chi, H.L., Wang, X. & Chan, A.P. 2018. A critical review of virtual and augmented reality (VR/AR) applications in construction safety. Automation in Construction, 86, pp. 150-162. https://doi.org/10.1016/j.autcon.2017.11.003        [ Links ]

    Liao, L., Teo, E.A.L. & Low, S.P. 2017. A project management framework for enhanced productivity performance using building information modelling. Construction Economics and Building, 17(3), pp. 1-26. https://doi.org/10.5130/AJCEB.v17i3.5389        [ Links ]

    Lin, C.L. & Lai, Y.C. 2020. An improved time-cost trade-off model with optimal labour productivity. Journal of Civil Engineering and Management, 26(2), pp. 113-131. https://doi.org/10.3846/jcem.2020.11663        [ Links ]

    Liu, J. & Lu, M. 2018. Constraint programming approach to optimizing project schedules under material logistics and crew availability constraints. Journal of Construction Engineering and Management, 144(7), pp. 1-15. https://doi.org/10.1061/(ASCE)CO.1943-7862.0001507        [ Links ]

    Liu, J., Yi, Y. & Wang, X. 2020. Exploring factors influencing construction waste reduction: A structural equation modeling approach. Journal of Cleaner Production, 276, article 123185. https://doi.org/10.1016/j.jclepro.2020.123185        [ Links ]

    Lorenzo-Seva, U., Timmerman, M. & Kiers, H. 2011. The Hull method for selecting the number of common factors. Multivariate Behavioral Research, 46(2), pp. 340-364. https://doi.org/10.1080/00273171.2011.564527        [ Links ]

    Mahyuddin, N., Jamaludin, N.M., Hussien, A., Akashah, F.W., Azmi, N.F., Cotgrave, A. & Riley, M. 2022. Assessing the impact of indoor plants towards physical indoor office building environment in hot and humid climates. Journal of Design and Built Environment, 22(1), pp. 34-54. https://doi.org/10.22452/jdbe.vol22no1.3        [ Links ]

    Manoharan, K., Dissanayake, P., Pathirana, C., Deegahawature, D. & Silva, R. 2023. Assessment of critical factors influencing the performance of labour in Sri Lankan construction industry. International Journal of Construction Management, 23(1), pp. 144-155. https://doi.org/10.1080/15623599.2020.1854042        [ Links ]

    McCutcheon, R. 2008. The generation of productive employment opportunities for the unskilled: Principles, potential and pitfalls of labour-intensive construction. In: 10th Path to Full Employment Conference/15th National Unemployment Conference, 4-5 December, Newcastle, NSW, Australia, pp. 4-5.         [ Links ]

    Momade, M.H., Shahid, S., Hainin, M.R.B., Nashwan, M.S. & Tahir Umar, A. 2022. Modelling labour productivity using SVM and RF: A comparative study on classifiers performance. International Journal of Construction Management, 22(10), pp. 1924-1934. https://doi.org/10.1080/15623599.2020.1744799        [ Links ]

    Morris, N.B., Levi, M., Morabito, M., Messeri, A., Ioannou, L.G., Flouris, A.D. et al. 2021. Health vs. wealth: Employer, employee and policy-maker perspectives on occupational heat stress across multiple European industries. Temperature, 8(3), pp. 284-301. https://doi.org/10.1080/23328940.2020.1852049        [ Links ]

    Nag, P.K., Gite, L.P. 2020. Ergonomics application in design of farm tools and equipment. In: Nag, P.K., Gite, L.P. Human-centered agriculture: Ergonomics and human factors applied. Springer, pp. 301-331. https://doi.org/10.1007/978-981-15-7269-2_12        [ Links ]

    Newman, T.J. 2020. Life skill development and transfer: They're not just meant for playing sports. Research on Social Work Practice, 30(6), pp. 643-657. https://doi.org/10.1177/1049731520903427        [ Links ]

    Nguyen, L.H. & Watanabe, T. 2017. The impact of project organizational culture on the performance of construction projects. Sustainability, 9(5), article 781, pp. 1-14. https://doi.org/10.3390/su9050781        [ Links ]

    Omopariola, E.D., Windapo, A., Edwards, D.J. & Thwala, W.D. 2020. Contractors' perceptions of the effects of cash flow on construction projects. Journal of Engineering, Design and Technology, 18(2), pp. 308-325. https://doi.org/10.1108/JEDT-04-2019-0099        [ Links ]

    Pallant, J. 2013. SPSS survival manual. A step by step guide to data analysis using IBM SPSS. Berkshire, U.K.: Open University Press.         [ Links ]

    Pornthepkasemsant, P. & Charoenpornpattana, S. 2019. Identification of factors affecting productivity in Thailand's construction industry and proposed maturity model for improvement of the productivity. Journal of Engineering, Design and Technology, 17(5), pp. 849-861. https://doi.org/10.1108/JEDT-10-2017-0109        [ Links ]

    Rahmanniyay, F. & Yu, A.J. 2019. A multi-objective stochastic programming model for project-oriented human-resource management optimization. International Journal of Management Science and Engineering Management, 14(4), pp. 231-239. https://doi.org/10.1080/17509653.2018.1534220        [ Links ]

    Rane, S.B., Potdar, P.R. & Rane, S. 2021. Development of project risk management framework based on industry 4.0 technologies. Benchmarking: An International Journal, 28(5), pp. 1451-1481. https://doi.org/10.1108/BIJ-03-2019-0123        [ Links ]

    Rossoni, L., Engelbert, R. & Bellegard, N. 2016. Normal science and its tools reviewing the effects of exploratory factor analysis in management. Revista de Administração, 51(2), pp. 198-211. https://doi.org/10.5700/rausp1234        [ Links ]

    Santos, R., Costa, A.A., Silvestre, J.D. & Pyl, L. 2019. Integration of LCA and LCC analysis within a BIM-based environment. Automation in Construction, 103, pp. 127-149. https://doi.org/10.1016/j.autcon.2019.02.011        [ Links ]

    Sen, A. 1999. Development as freedom. New York: Alfred Knopf.         [ Links ]

    Sheikh, A., Lakshmipathy, M. & Prakash, A. 2016. Application of queuing theory for effective equipment utilization and maximization of productivity in construction management. International Journal of Applied Engineering Research, 11(8), pp. 5664-5672.         [ Links ]

    Sibande, A.S. & Agumba, N.J. 2018. Construction work productivity in South Africa: A case of Gauteng province construction industry. In: Chau, K.W. (Ed.). Proceedings of the 21st International Symposium on Advancement of Construction Management and Real Estate. Springer, Singapore, pp. 523-533. https://doi.org/10.1007/978-981-10-6190-5_47        [ Links ]

    Singh, Y.K. 2006. Fundamental of research methodology and statistics. New Delhi, India: New Age International.         [ Links ]

    Taber, K.S. 2018. The use of Cronbach's Alpha when developing and reporting research instrumets in science education. Research in Science Education, 48, pp. 1273-1296. https://doi.org/10.1007/s11165-016-9602-2        [ Links ]

    Taheri Amiri, M.J., Haghighi, F., Eshtehardian, E. & Abessi, O. 2018. Multi-project time-cost optimization in critical chain with resource constraints. KSCE Journal of Civil Engineering, 22(10), pp. 3738-3752. https://doi.org/10.1007/s12205-017-0691-x        [ Links ]

    Tavakol, M. & Dennick, R. 2011. Making sense of Cronbach's Alpha. International Journal of Medical Education, 2, pp. 53-55. https://doi.org/10.5116/ijme.4dfb.8dfd        [ Links ]

    Thwala, D.W. 2011. Public works programmes as a tool to address unemployment and skills shortages among the youth in South Africa. African Journal of Business Management, 5(15), pp. 6011-6020.         [ Links ]

    Tsai, F.M., Bui, T.D., Tseng, M.L., Wu, K.J. & Chiu, A.S. 2020. A performance assessment approach for integrated solid waste management using a sustainable balanced scorecard approach. Journal of Cleaner Production, 251, article 119740, pp. 1-16. https://doi.org/10.1016/j.jclepro.2019.119740        [ Links ]

    Tsehayae, A.A. & Fayek, A.R. 2016. System model for analysing construction labour productivity. Construction Innovation, 16(2), pp. 203-228. https://doi.org/10.1108/CI-07-2015-0040        [ Links ]

    Udris, I. & Nibel, H. 2017. Situational diagnosis vs. social construction of jobs meta-analysis of the questionnaire "Subjective Job Analysis". In: Landau, K. (Ed.). Recent developments in job analysis. London, UK: Routledge, pp. 79-80. https://doi.org/10.4324/9781315213712-7        [ Links ]

    Wang, J., Cao, J., Sherratt, R.S. & Park, J.H. 2018. An improved ant colony optimization-based approach with mobile sink for wireless sensor networks. The Journal of Supercomputing, 74(12), pp. 6633-6645. https://doi.org/10.1007/s11227-017-2115-6        [ Links ]

    Wang, T., Abdallah, M., Clevenger, C. & Monghasemi, S. 2021. Time-cost-quality trade-off analysis for planning construction projects. Engineering, Construction and Architectural Management, 28(1), pp. 82-100. https://doi.org/10.1108/ECAM-12-2017-0271        [ Links ]

    Weng, Y., Li, M., Ruan, S., Wong, T.N., Tan, M.J., Yeong, K. & Qian, S. 2020. Comparative economic, environmental and productivity assessment of a concrete bathroom unit fabricated through 3D printing and a precast approach. Journal of Cleaner Production, 261, article 121245, pp. 1-13. https://doi.org/10.1016/j.jclepro.2020.121245        [ Links ]

    Yeom, D.J., Yoo, H.S., Kim, J.S. & Kim, Y.S. 2022. Development of a vision-based machine guidance system for hydraulic excavators. Journal of Asian Architecture and Building Engineering, 22(3), pp. 1-18. DOI: 10.1080/13467581.2022.2090365        [ Links ]

    Zhang, J., Zi, L., Hou, Y., Wang, M., Jiang, W. & Deng, D. 2020. A deep learning-based approach to enable action recognition for construction equipment. Advances in Civil Engineering, Article number: 8812928, pp. 1-14. https://doi.org/10.1155/2020/8812928        [ Links ]

    Zhang, X., Azhar, S., Nadeem, A. & Khalfan, M. 2018. Using building information modelling to achieve lean principles by improving efficiency of work teams. International Journal of Construction Management, 18(4), pp. 293-300. https://doi.org/10.1080/15623599.2017.1382083        [ Links ]

    Zhao, Y., Chen, W., Arashpour, M., Yang, Z., Shao, C. & Li, C. 2022. Predicting delays in prefabricated projects: SD-BP neural network to define effects of risk disruption. Engineering, Construction and Architectural Management, 29(4), pp. 1753-1776. https://doi.org/10.1108/ECAM-12-2020-1050        [ Links ]





    Received: January 2023
    Peer reviewed and revised: March 2023
    Published: June 2023





    DECLARATION: The author(s) declared no potential conflicts of interest with respect to the research, authorship, and/or publication of this article.
